Highway 63

The Government of Alberta is committed to continuing to improve Highway 63 for the safety of motorists, including improving traffic flow within Fort McMurray. This is about investing in a region that makes a tremendous contribution to the province’s economy. You can view the latest Highway 63 construction videos and photos.

Highway 63 Fact Sheet

Highway 63 - 2013 construction update

Highway 63 projects recently tendered and currently under construction:

  • 27 km of twinning grading near Wandering River - $42 million – fall 2013 completion
  • Climbing lanes North of Crow Lake Provincial Park to South of Highway 881 junction - $7.1 million - summer 2013 completion
  • 55 km of tree clearing South of House River to North of Mariana Lake - $3 million - spring 2013 completion
  • 17 km of twinning grading from North of Algar Tower to South of Horse Creek – $33 million - fall 2013 completion
  • 15 km of twinning grading from North of Mariana Lake to North of Algar Tower – $18 million - fall 2013 completion
  • 17 km of twinning grading from North of La Biche River to South of Wandering River – $35 million – Spring 2014 completion
  • Slide repairs South of Highway 881 - $2 million – summer 2013 completion

Highway 63 projects to be tendered in the next few months:

  • 31 km of twinning (grading/paving/bridges) from South of House River to North of Crow Creek - fall 2015 completion
  • 28 km of twinning (grading/paving/bridges) from South of Horse Creek to North of Hanging stone River - fall 2015 completion
  • La Biche River Bridge 14 km north of Atmore – Summer 2014 completion

Current projects in Fort McMurray include:

  • Confederation Way and Thickwood Boulevard interchanges are open with temporary ramps. Construction continues and will be complete by fall 2013
  • Construction continues on Steinhauer, Franklin and Grant MacEwan Bridges over the Athabasca River with a 2014 completion target
  • Work also continues to provide access for the Parsons Creek Development with a 2015 completion date

Budget 2013 Update

Budget 2013 confirms that construction is proceeding on Highway 63. Funding for this project stays the same and accelerated construction remains on track for 2016 completion. This project demonstrates our focus on supporting market access and economic opportunities in the core network, promoting safe travel for industry and Albertans, and improving flow of goods and services.

Transportation is one element of Budget 2013, and focuses on expanding market access through work on core infrastructure and key corridors. This benefits all Albertans, regardless of where they live, and is a smart use of taxpayer dollars.

Planned improvements to Highway 881 were announced but not tendered. All Highway 881 improvements will be deferred under the current budget situation, including the extension north of Anzac and connection to Highway 69.

However, we will see another three years of heavy construction activity along Highway 63 as twinning continues on an accelerated schedule for completion in the fall of 2016. In addition to construction dollars already spent last year, $562 million remains in this budget to complete Highway 63 twinning. $442 million of that will be spent over the next three years.

Ten years ago, Highway 881 was a gravel road. We have invested over $1 billion in Highways 63 and 881 and other projects in this region, which makes a tremendous contribution to our economy.

Our focus in the next few years will be expanding market access through work on our core transportation network, and maintaining our infrastructure investments.

Like every year, the three-year construction program – which includes priority projects throughout the province – will be posted online. Albertans will know how and where their tax dollars are being spent. Albertans will know how and where their tax dollars are being spent.

  • We balance a number of issues in determining priorities:
    • traffic volumes
    • condition of existing infrastructure
    • supporting increased economic activity
    • safety records
    • supporting new developments
    • available funding

Highway 63 News

April 19, 2013 – News Release – Highway 63 twinning update – countdown to 2016
November 13, 2012 – News Release – Alberta government acts to accelerate Highway 63 twinning
November 7, 2012 – News Release – New Confederation Way interchange increases safety, convenience for motorists
October 19, 2012 – News Release – Highway 63 twinning fast-tracked for fall 2016 completion
October 19, 2012 – News Release – 36 kilometres of newly-twinned blacktop on Highway 63 opens October 22
August 28, 2012 – News Release – Accelerated Highway 63 passing lane construction increases safety
July 24, 2012 – News Release – Premier Redford drives forward with actions on Highway 63
July 17, 2012 – News Release – Highway 63 projects go to tender for passing lanes, grading, and clearing
June 29, 2012 – News Release – Highway 63 report highlights safety solutions
– MLA Report – "Towards a Safer 63" - Report of the Special Advisor on Highway 63
– News Conference Audio – Minister Mclver and MLA Mike Allen
June 14, 2012 – Telephone Townhall – You can listen to the 90-miniute town hall broadcast.
May 22, 2012 – News Release – Premier Redford names Special Advisor on Highway 63.

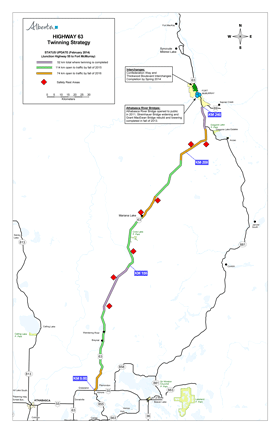

Twinning Highway 63

  • The Government of Alberta has committed to twinning Highway 63 by 2016.
  • The government of Alberta initially committed to twinning of Highway 63 from Highway 55 to Fort McMurray in 2006.
  • In addition to 16 km of twinning that was completed south of Fort McMurray and 17 km of twinning north of Fort McMurray, the Alberta government opened 36 km of newly twinned four-lane divided highway north of Wandering River 8 months ahead of schedule in November 2012.
  • We continue to make progress on the twinning and have completed much of the initial work, including surveying, tree clearing, grading and a number of consultations. Functional planning work, detailed engineering and design work, and land purchases are ongoing. Highway 63 is unique in Alberta when it comes to construction challenges, including continuous muskeg and boreal forest, pipeline crossings, and the size of industrial vehicles.
  • The completion of 265 km of paving on Highway 881 in 2006 provided an alternate route to Fort McMurray and was an important step in taking the pressure off Highway 63, while allowing the twinning to progress.

Summary of current and recently completed projects

Since 2005, the province has invested more than $1 billion to support Highway 63 and 881 projects, providing critical highway infrastructure for the Athabasca oil sands region.

Five-lane Athabasca River Bridge ($127 million)..................................................... opened 2011

Thickwood Blvd Interchange and Confederation Way Interchange ($220 million) start opening 2012

Steinhauer Bridge rebuild ($51.7 million).......................................................... opening fall 2013

Grant MacEwan Bridge rebuild ($23.3 million)........................................... opening summer 2014

Twinning Highway 63 - 17 km north of Ft. McMurray ($80 million)............................. opened 2008

Twinning Highway 63 - 16 km south of Fort McMurray ($53 million)........................... opened 2008

Twinning Highway 63 - 36km north of Wandering River ($84 million)..................... opening fall 2013

Paving Highway 881 – converting 100km gravel to pavement ($62 million).............. completed 2006

Other projects:

Widened and repaved 5km Hwy 63 to Beacon Hill ($17 million)............................ completed 2008

Intersection improvement on Hwy 63 near Fort McKay ($4 million)............................ opened 2008

Other rehabilitation projects, including repaving 70km of Hwy 63 and adding passing lanes ($85 million)

Capital projects in support of oilsands development such as the base pave of Hwy 813 and widening of Hwy 36 ($99 million)

Rehabilitation projects within the Athabasca Oilsands Area in support of oilsands development such as the overlays of Hwy 36 and Hwy 55 ($43 million)

Other costs include - Engineering and planning work, land acquisition, and utility relocations

Safety Partnerships

Safety on Highway 63 must be addressed as a priority. Twinning is an important part of improving safety. The Government of Alberta has also taken many additional steps on behalf of Albertans to make Highway 63 a safer road to travel. More sheriffs, increased enforcement, increased signage, education, driver education, and the coordination and support of emergency services are all steps that have been taken to date. While overall collision rates on Highway 63 are slightly below provincial average for roads with similar traffic volumes, this highway is of great concern.

The five-year collision rate Highway 63 from the junction of Highway 55 to the south city limits of Fort McMurray has decreased to 81.87 collisions per 100 million vehicle kilometers for 2006-2010 compared to 84.97 for 2005-2009. This is below the provincial average of 107 collisions per 100 million vehicle kilometers for comparable two-lane undivided highways. A large percentage of the collisions on Highway 63 (40 per cent) continue to involve animals.

Both short-term and long-term safety measures, along with the twinning of Highway 63, will be key to the plans going forward.

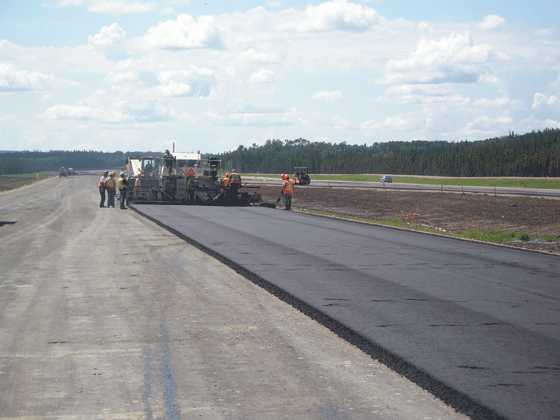

Paving work is underway on the Highway 63 twinning north of Wandering River. As of July 24, construction crews have completed 14 kilometres of the first lift of pavement and within this section, crews have also completed 7 kilometres of the second and final lift of pavement. (July 5, 2012)
